The honest answer to “how long does an EV charger installation take?” has two parts. The on-site fitting itself is usually 3–4 hours. The end-to-end timeline — from your first enquiry to plugging in your car — is anywhere from a week to two months depending on grants, DNO notifications, factor permissions, and whether your consumer unit needs work.

This guide separates the two, walks through every stage in the order it actually happens, and flags the Scottish-specific bits (SP Energy Networks notification, factor consent for tenements, OZEV in Scotland) that catch people out.

Most standard EV charger installations across Glasgow and Central Scotland are completed within a single day, with only a few situations requiring additional work or approvals.

Infographic

How long does EV charger installation actually take?

A visual walkthrough of the typical install timeline across Glasgow and Central Scotland.

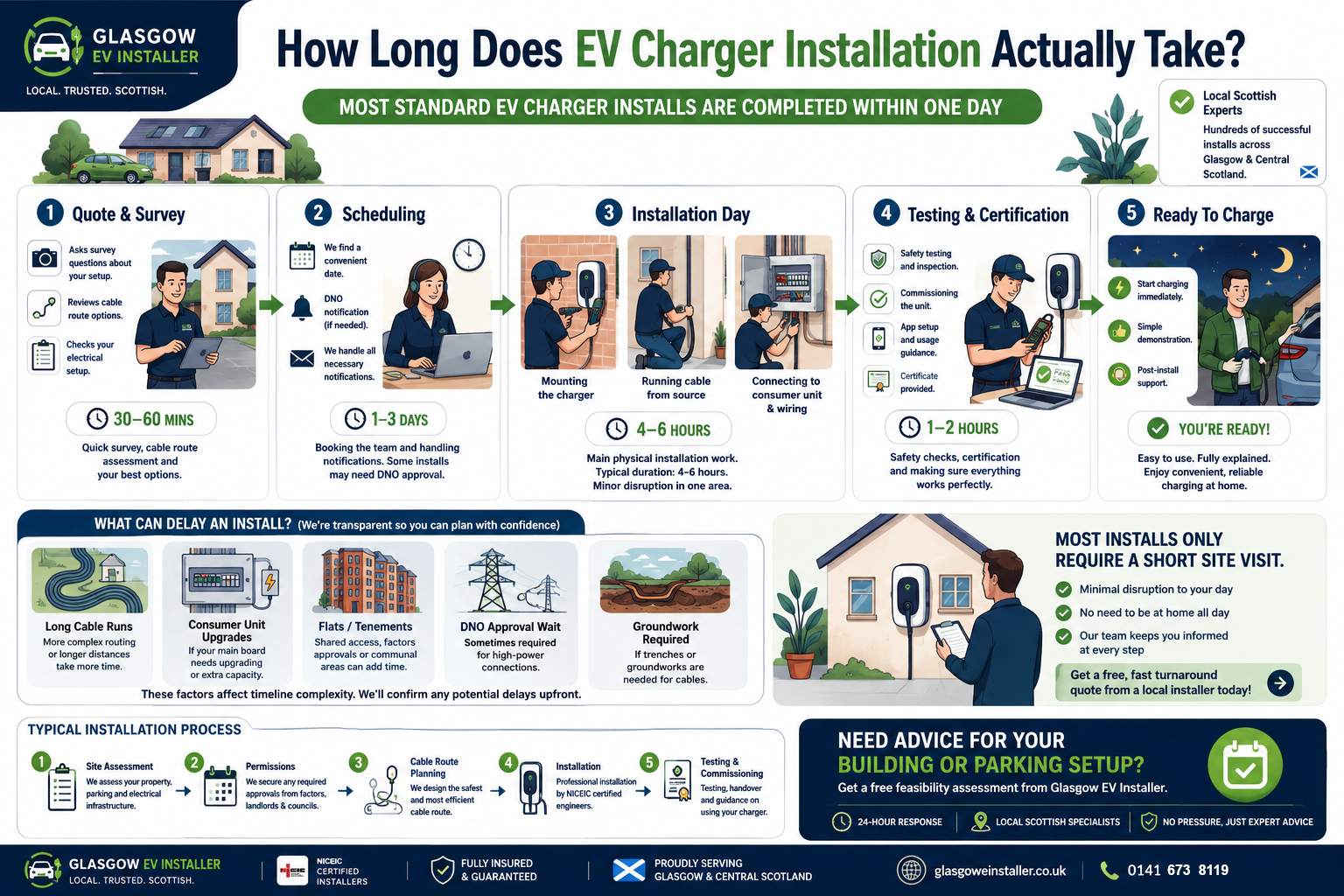

Timeline infographic showing the EV charger installation process including survey, scheduling, installation, testing and commissioning in Glasgow and Scotland.
Most standard EV charger installations are completed within one day, although factors such as long cable runs, flats, consumer unit upgrades or DNO approvals may extend the process.
90%
of installs completed in one day

Based on standard home installations

Most standard EV charger installations only require a short site visit.

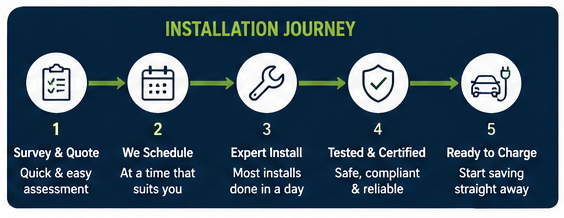

EV charger installation process graphic showing quote, scheduling, installation, testing and charging readiness for Scottish homeowners.
Most EV charger installations follow a simple step-by-step process from survey and scheduling through to testing and charging at home.

Most standard installations are completed within one day with minimal disruption to the property.

Ready to start your installation journey?

Get a free installation assessment today Local Scottish EV charging specialists
Myth vs fact infographic explaining EV charger installation in flats and electrical safety for Scottish homeowners.
Many common concerns about EV charging are based on outdated assumptions or misunderstandings about modern installations.

Professional EV charger installers assess your property, electrical capacity and permissions before recommending a safe installation approach.

Unsure whether your property can support EV charging?

Get free advice from Glasgow EV Installer Local Scottish specialists • No pressure guidance
Before and after EV charger installation showing a Scottish home upgraded with a professionally installed wall charger.
A professionally installed home EV charger can provide a cleaner, safer and more convenient charging setup for everyday use.

Most standard installations are completed within one day with minimal disruption.

Ready to install home EV charging?

Get a fast, free quote Local Scottish specialists • NICEIC certified • No pressure advice
3–4 hrs
On-site fitting
7–14 days
Standard end-to-end
≤ 28 days
DNO notification window
Process diagram
Infographic coming soon

From first enquiry to first charge — the full process

  1. 1Enquiry & photos sent
  2. 2Site survey (30–60 min)
  3. 3Fixed quote returned
  4. 4OZEV grant approval (if eligible)
  5. 5Installation day — on-site, 3–4 hours
  6. 6Testing, certification & app pairing
  7. 7DNO notification filed (within 28 days)
Process diagram placeholder — each step is admin unless marked on-site.
Eighty percent of the wait is paperwork and scheduling. The electricians are on your wall for half a working day.
Stephen David, Glasgow EV Installer

End-to-end timeline at a glance

StageWhat happensTypical durationType
1. Enquiry & photosYou send photos of meter, fuse box, parking, cable routeSame dayAdmin
2. Site surveyInstaller visits or does a video survey30–60 min, booked within 2–5 daysAdmin
3. Fixed quoteCharger model, cable run, extras priced upWithin 24 hrs of surveyAdmin
4. DNO notificationNotification (not approval) for 7kW/32A in ScotlandFiled by installer; no wait for standard 7kWAdmin
5. OZEV grant approval (if eligible)Evidence pack → OZEV portal5–10 working daysAdmin
6. SchedulingDiary slot booked1–10 days depending on installer loadAdmin
7. Installation dayMount, run cable, wire CU, commission3–4 hours (standard)On site
8. Testing & certificationEICR-style test, BS 7671 cert, charger paired to app30–45 min, same dayOn site
9. DNO notification submittedWithin 28 days of energisationFiled after installAdmin

Admin time vs actual installation time

This is the single most useful distinction to understand. The electricians are on your wall for 3–4 hours. Everything else is paperwork and scheduling — and that's where the delays come from.

CategoryWhat it coversTypical share of total wait
Admin / waitingSurvey booking, quote, grant, DNO, scheduling≈ 80–95% of total elapsed time
Actual installation workCable, mounting, wiring, commissioning, test≈ 5–20% of total elapsed time

If your installer is well-organised and you respond to emails quickly, a standard Glasgow driveway install can be done in 7–10 days from first enquiry. If you're chasing OZEV grant evidence and factor consent, the same physical job can take 6–8 weeks to reach the point where an electrician turns up.

Stage 1 — Survey (30–60 minutes)

A good installer either visits in person or does a video survey. They'll check: main fuse rating (typically 60A, 80A or 100A in Scotland), consumer unit condition, earthing arrangement (TN-S, TN-C-S/PME, or TT — common in older Scottish properties), proposed cable route, and parking layout. Most surveys are booked within 2–5 working days of your enquiry.

Stage 2 — DNO notification (the bit most guides skip)

In Scotland, your DNO is SP Energy Networks (most of the central belt and south) or SSEN (Highlands, north-east). For a single 7kW (32A) home charger, only post-installation notification is required — there's no waiting period before fitting. The installer has 28 days after the install to file it.

Pre-approval (which can take 6–10 weeks) is only needed if you're combining the charger with battery storage, solar PV uplift, a second charger pushing the property above 32A total, or a 22kW three-phase install. Most homes don't need it.

Stage 3 — OZEV grant approval (5–10 working days, if eligible)

Eligibility is mainly flats and rental properties — see the OZEV grant Scotland 2026 guide for who qualifies. Once your installer submits your evidence (V5C or lease agreement, parking proof, landlord consent for rentals), authorisation is usually back inside two weeks. Don't book the fitting date until authorisation is in — claims can't be backdated.

Stage 4 — Scheduling (1–10 days)

Lead times depend on installer demand. Spring (March–May) and the run-up to Christmas are the busiest periods in central Scotland. Quiet weeks can mean a fitter on your wall in 24–48 hours; peak weeks can be 2–3 weeks out.

Stage 5 — Installation day, hour by hour

TimeWhat's happening
0:00 – 0:30Arrival, dust sheets down, isolate the supply, re-check the cable route
0:30 – 1:30Run the cable — clipped externally, drilled through the wall, or in conduit
1:30 – 2:30Mount the charger, terminate cable, fit dedicated MCB/RCBO in the consumer unit
2:30 – 3:15Energise, commission via the manufacturer app, pair to Wi-Fi/4G
3:15 – 3:45Insulation resistance, earth fault loop, RCD/Type-A+6mA test, fill in BS 7671 certificate
3:45 – 4:00Walkthrough with you: app, scheduling, smart tariff setup, paperwork handed over

Standard vs complex vs flat — realistic timings

ScenarioOn-site fitting timeEnd-to-end timeline
Standard driveway, modern CU, sub-10m cable run3–4 hours7–10 days
Older property needing CU upgrade or earth rod (TT)5–7 hours2–4 weeks
Long cable run (10–25m), conduit, drilled through stone5–8 hours, possibly 2 days2–4 weeks
Flat with allocated bay, factor-managed building5–7 hours on the day4–8 weeks (factor consent)
Tenement with shared close and communal supplySurvey may be 2 visits; install 6–8 hours6–10 weeks
Conservation area / listed building4–6 hours, restricted external work4–12 weeks (planning)

Scottish factor & tenement reality check

Tenement and modern flat installs in Glasgow, Edinburgh, Paisley and Stirling are almost always rate-limited by factor consent, not by the electrician's calendar. James Gibb, Hacking & Paterson, Lomond and Ross & Liddell typically respond inside 2–4 weeks; some smaller factors take 6–8. Start the consent conversation before you book the survey — it runs in parallel with everything else.

For the full tenement playbook, read our Glasgow tenement EV charger guide.

Common causes of delay (and how to avoid them)

  • Old consumer unit — wylex/MK fuse boxes from pre-2008 usually need replacing. Add 1–2 hours and ~£300–£450; flag it at survey, not install day.
  • TT earthing (no PME / no TN-S) — common in rural Aberdeenshire, parts of Lanarkshire, older detached homes. Needs an earth rod; adds 1–2 hours.
  • Missing OZEV evidence — landlord consent letters and lease scans are the #1 cause of grant delays. Get them ready before you apply.
  • Wi-Fi blackspot at the parking bay — many smart chargers need connectivity. Ohme and Zappi ship with a SIM as standard; others need a mesh extender.
  • Booking before grant approval — OZEV claims can't be backdated. Wait for the authorisation email.
  • Stone walls in tenements — drilling through 600mm sandstone takes longer and may need core drilling. Add an hour.

Frequently asked questions

Can I get an EV charger installed next day?

Occasionally, yes — for a cash-paying customer with a modern consumer unit, no grant, and an installer with a free slot. Realistically, plan for a week.

Do I need to be home for the install?

Yes. The supply needs to be isolated, you need to sign off the certificate, and the installer will walk you through the app pairing.

Will my power be off all day?

No — typically only 30–60 minutes total while the consumer unit is opened up and the new circuit is added.

How long is the certificate valid?

The BS 7671 minor works / installation certificate doesn't expire, but a periodic EICR every 5–10 years is recommended for the rest of the property.

Get a realistic timeline for your property

Every Scottish home is a slightly different timeline. We connect Glasgow and central Scotland homeowners with NICEIC-approved installers who survey, file the OZEV claim and DNO notification for you, and book a fitting date — typically inside 7–14 days for a standard install.

Get your installation timeline and quote →
